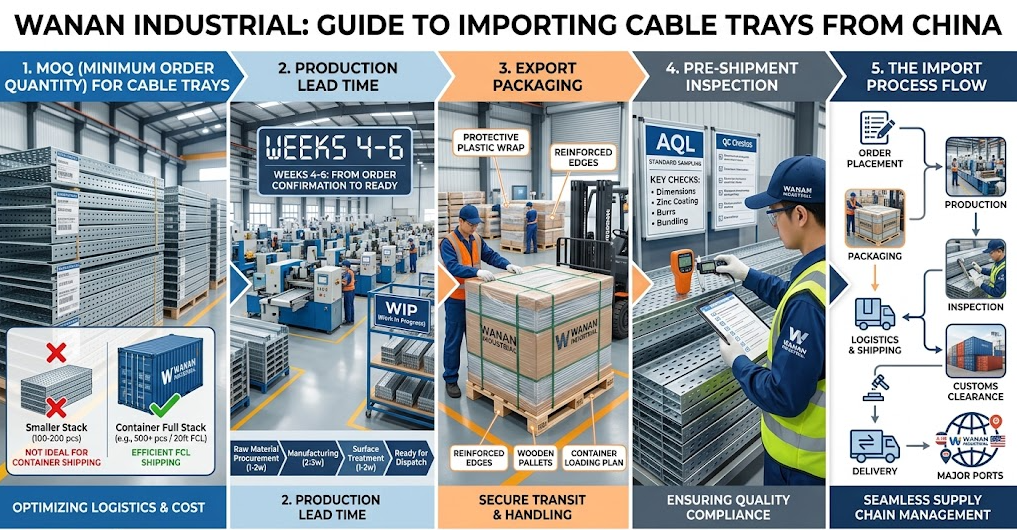

Sourcing cable tray from a Chinese manufacturer can cut material costs significantly compared to buying locally, but the process involves a different set of questions than a domestic purchase — minimum order quantities, production lead time, export packaging, and quality inspection all work differently across borders. This guide walks through what to expect at each stage, so you can plan a realistic timeline and avoid surprises at the port.
MOQ for cable tray varies by product type and whether the order is for standard stock sizes or custom specifications. Standard ladder, perforated, or trough-type tray in common widths and finishes typically has a lower MOQ than custom profiles, non-standard lengths, or special coatings, since standard sizes can often be produced from existing tooling and material on hand.
Standard vs. custom specification. A standard width, height and finish combination is far easier to meet with a low MOQ than a custom profile requiring dedicated tooling or a special material order.
Material and finish. Stainless steel or specialty coatings often carry a higher MOQ than standard hot-dip galvanized steel, since the raw material itself is typically purchased in fixed mill quantities.
Container efficiency. Many suppliers set MOQ around what efficiently fills a portion of a shipping container, since partial-container shipments usually cost more per unit to ship.
Buyers working on a smaller first order should ask directly whether a trial or sample order is possible below the standard MOQ — many manufacturers accommodate a smaller first shipment to establish the relationship before committing to full-volume orders.
Lead time for cable tray orders typically breaks down into three stages: order confirmation and material procurement, production, and transit time to the destination port. Standard products with materials already in stock move faster through the first stage, while custom specifications requiring new tooling or specific material grades extend it.
Order size. Larger orders naturally take longer to produce than smaller ones, even with the same production line capacity.
Finish type. Hot-dip galvanizing, powder coating, or specialty finishes each add their own processing time after the base tray is formed.
Season and factory capacity. Lead times can extend around major Chinese holidays (particularly Chinese New Year), when factories close for one to several weeks and order queues build up beforehand.
Shipping method. Sea freight is the standard for bulk cable tray orders and takes considerably longer than air freight, which is typically reserved for urgent, smaller shipments given the weight and volume of steel products.
Buyers with a fixed installation deadline should confirm production lead time and transit time separately, and build in buffer time around major holiday periods rather than assuming year-round consistency.
Export packaging for cable tray is built around protecting the product through loading, ocean transit, and unloading, which is a rougher handling path than most domestic deliveries. Standard practice typically includes bundling tray sections with strapping, protective corner guards to prevent damage to galvanized or coated surfaces, and palletizing or crating for forklift handling at the destination port.
Whether sections are individually wrapped or bundled, and how bundles are protected from surface scratching during transit
Packaging method for accessories (splice plates, clamps, fasteners) — small parts should be boxed separately and clearly labeled to avoid loss or confusion during unloading
Export carton or crate marking standards, including weight, dimensions, and item codes matching the packing list, which speeds up customs clearance and on-site unloading
Whether moisture protection is included for ocean freight, particularly relevant for uncoated or lower-grade finish products
Quality inspection for an overseas order typically happens at one or more of three points: in-process inspection during production, pre-shipment inspection once goods are complete, and incoming inspection after arrival at the destination. Relying only on incoming inspection means any defect is discovered after the goods have already crossed the ocean, which is far more costly to resolve than catching it before shipment.
Dimensional accuracy — width, height, length and hole pattern checked against the purchase order specification
Coating thickness — galvanizing or coating thickness measured against the specified standard (such as ASTM A123 for hot-dip galvanizing)
Visual and surface quality — checking for coating defects, weld quality, and any shipping-related surface damage before loading
Packaging compliance — confirming packaging matches what was agreed, since this is also the last opportunity to catch a packaging issue before it becomes a transit problem
Buyers can request inspection reports and photos directly from the manufacturer's quality team, or engage an independent third-party inspection service for an added layer of verification — particularly worthwhile for larger orders or a first-time supplier relationship.
Specification and quotation — confirm product specification, finish, quantity, and whether the order meets standard MOQ or requires a custom arrangement
Order confirmation and deposit — production typically begins once terms and deposit are confirmed
Production — lead time depends on order size, finish complexity, and factory queue at the time of order
Pre-shipment inspection — conducted once production is complete, before the goods are packed for export
Packaging and loading — export packaging applied, goods loaded into container
Ocean/air transit — sea freight is standard for bulk orders; transit time depends on origin and destination ports
Customs clearance and delivery — import documentation, duties, and final delivery to site
Importing cable tray from China involves more planning touchpoints than a domestic order, but each one — MOQ, lead time, packaging, and inspection — is manageable with the right questions asked upfront. Confirming MOQ flexibility for first orders, separating production lead time from transit time, specifying export packaging requirements clearly, and building in a pre-shipment inspection step are the practical steps that turn an overseas purchase into a predictable, repeatable process rather than a one-off gamble.
Many manufacturers can accommodate a smaller trial order below their standard MOQ, particularly for standard (non-custom) specifications, to establish the relationship before committing to full-volume orders. This is worth asking about directly rather than assuming the published MOQ is fixed.
Factories typically close for one to several weeks around Chinese New Year, and order queues build up in the weeks before the holiday as factories try to clear production ahead of the shutdown. Placing orders with extra buffer time in the month leading up to the holiday period helps avoid delays.
It's not strictly necessary, but it adds a layer of verification that catches dimensional, coating, or packaging issues before the goods leave the country — at which point any defect becomes far more expensive and time-consuming to resolve. It's especially worth considering for larger orders or a new supplier relationship.
